Skip to Content
How-to (step by step)Job ManagerInside a job — item detail

Inside a job — the item detail

Lite+

Click a job’s number on the Job Manager to open its item detail — every item in the job, with a task grid running across the top. Each task cell shows progress (green = done, grey = not applicable) and a play marker on the tasks still open to claim. Part-Level Tasks (like Admin or Invoicing) sit above the grid with their own Start buttons.

The item right-click menu

Right-click any item row for its menu. Each action opens its own dialog; where a full how-to exists it’s linked.

  • View Item Paperwork — open the item’s worksheet to view and mark it up. See View & mark up item paperwork.
  • Hold Item — pause a single item without holding the whole job.
  • Item Properties — edit the item’s details.
  • View Order Information — see what’s been ordered for the item. See Goods to order.
  • View Note — read the note held against the item.
  • View Incomplete Task — jump to the item’s next unfinished task.
  • Raise NCP… / View NCP… — log or review a non-conforming product for the item. See Raise an NCP.
  • Change Item Quantity — adjust how many of the item the job needs.
  • Add New Item — add an item straight into the part, seeding the tasks it needs. See Adding a new item below.
  • Remove Item — take an item off the job. See Part items.
  • Admin: Claim All Tasks Complete / Claim All Time-Based Tasks Complete — supervisor shortcuts to mark an item’s tasks finished.

The item actions in detail

Hold Item

  1. Right-click the item and choose Hold Item.
  2. Enter a reason for the hold.
  3. Confirm Hold — just that item pauses (the whole job keeps moving); release it the same way.

Item Properties

  1. Right-click the item and choose Item Properties.
  2. Edit the item’s details — dimensions, name, item note — and use the Tasks and Documents tabs for its task list and files.
  3. Save. To add another item, use Add New Item.

Change Item Quantity

  1. Right-click the item and choose Change Item Quantity.
  2. Enter the new quantity. Task minutes are scaled proportionally to match.
  3. Apply.

Setting a task’s status

If you can edit tasks (Administrators, Office and Production by default), you can set a task to Complete, In Progress or Not Started without anyone claiming time against it. You can also take a completed task back off complete. The submenu only offers the statuses the task isn’t already in.

For every item on a job part, from the main board: turn on View Settings → Detailed view, right-click a job’s task cell and choose Task Status: task name, then the new status.

Main board task cell right-click menu — Task Status submenu
1. Right-click a job's task cell in Detailed view and choose Task Status — the change applies to every item on the job part.

Each choice asks you to confirm in an Admin: Set Task Status popup. Everything that follows from a task’s status moves with it: the part’s stage, delivery and install dates, the site measure stage and the ordered/received dates. Taking a task back off complete rolls those back too.

Admin: Set Task Status confirmation popup
2. Every change asks first. Moving a task off Complete also rolls back its completion dates and any delivery, install or site-measure state that came from it.

Inside a job (the item detail):

  • One item: right-click the item’s cell under a task column and choose Task Status: task name, then the new status.
  • Every item on the part: right-click the task’s column header and choose All Items — Task Status: task name, then the new status.
Item task cell right-click menu — Task Status submenu
3. Right-click one item's task cell to set that task for just that item.
Task column header right-click menu — All Items — Task Status
4. Right-click the task's column header to set it for every item on the part at once.

It’s refused, with a message saying why, when someone is clocked on that task (stop their claim first) or when the task is your invoicing task. That one follows the job part’s Invoiced tick.

Adding a new item

Add New Item opens one dialog that grows as you fill it in — you enter the item’s details, then pick its product and choose which tasks to seed.

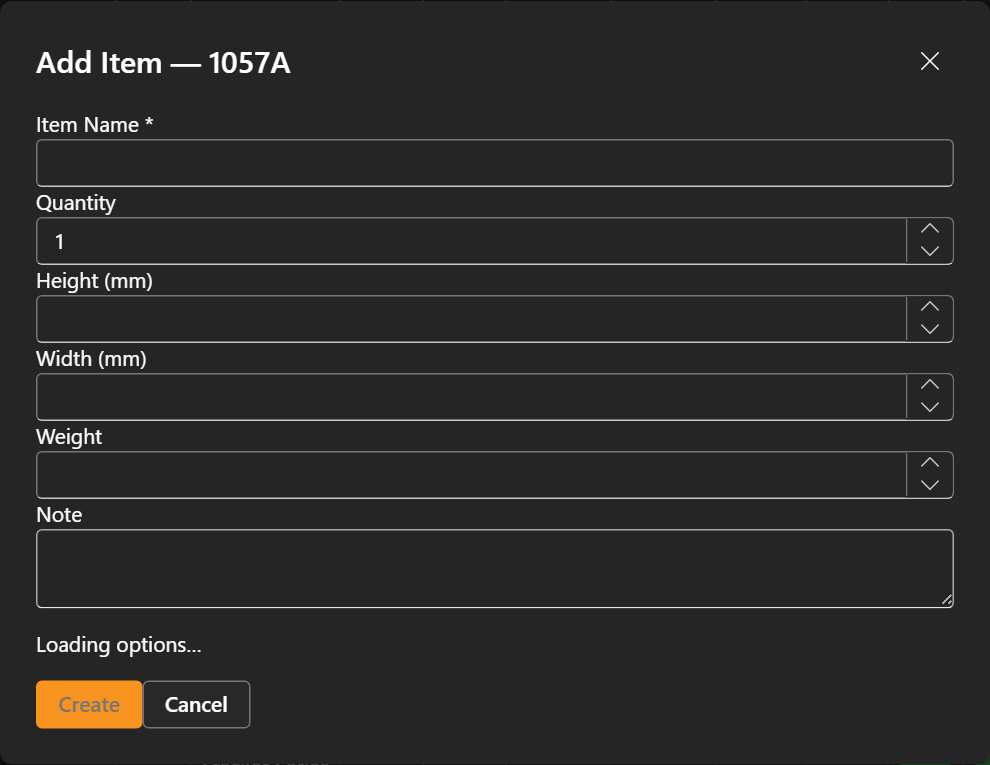

Add Item dialog — item details
1. Enter the item's details: Item Name (required), Quantity, Height, Width, Weight and an optional Note. The dialog loads the product options while you type.
  1. Right-click the item row (or use the item toolbar) and choose Add New Item.
  2. Fill in the Item Name (required), Quantity, and the Height / Width / Weight and Note if you need them.
  3. Once the options load, pick the Product System and Product Type (both required) — these define the item and drive its default tasks.
  4. Under Tasks to seed, tick the tasks this item needs (SM — Site Measure, OM — Order Metal, OH — Order Hardware, OG — Order Glass, OL — Order Liners, PW — Paperwork, MR — Metal Received, HR — Hardware Received, and so on) and set their planned minutes. Unchecked tasks are not created, so only seed the work that applies.
  5. Create — the item is added to the part with just those tasks on its grid.

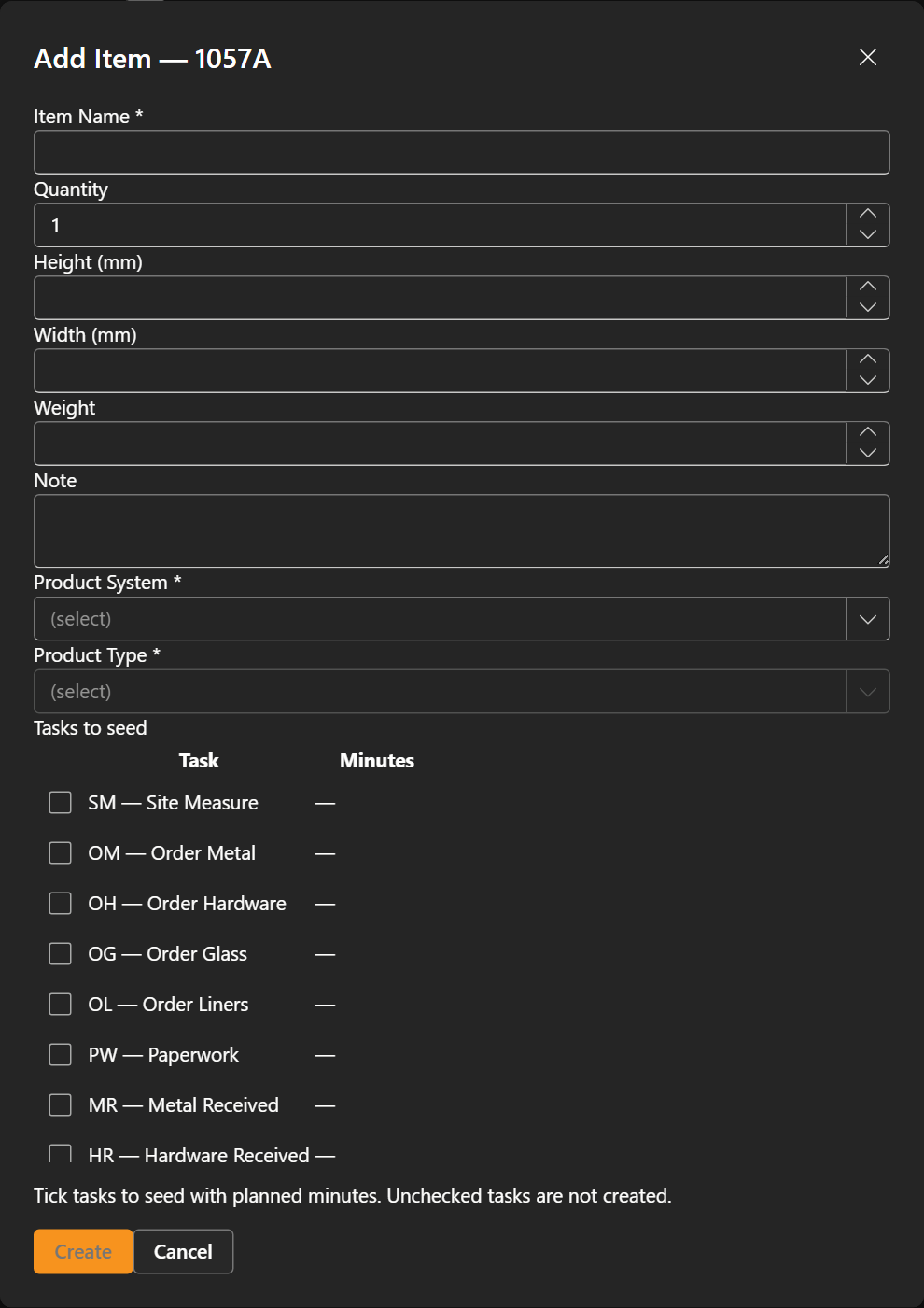

Add Item dialog — Product System, Product Type and Tasks to seed
2. Choose the Product System and Product Type, then tick the tasks to seed with planned minutes. Unchecked tasks are not created — so the item only carries the work it actually needs.

You need to Select Worker (sign in to the kiosk) before you can start tasks or open item paperwork. Right-clicking a job on the main board opens a different menu — see The job right-click menu.
